A Milestone / Task is created using the same steps and attributes. Unlike a task, however, a Milestone represents the end of a workflow and so does not have any successor tasks.

Any Milestone can be turned into a task by specifying another task as its successor. However, this linking is prohibited for a Master Level Milestone as it represents the end of a workflow, so it has no successor tasks and serves as the basis for determining Last Responsible Moment (LRM) dates for a workflow.

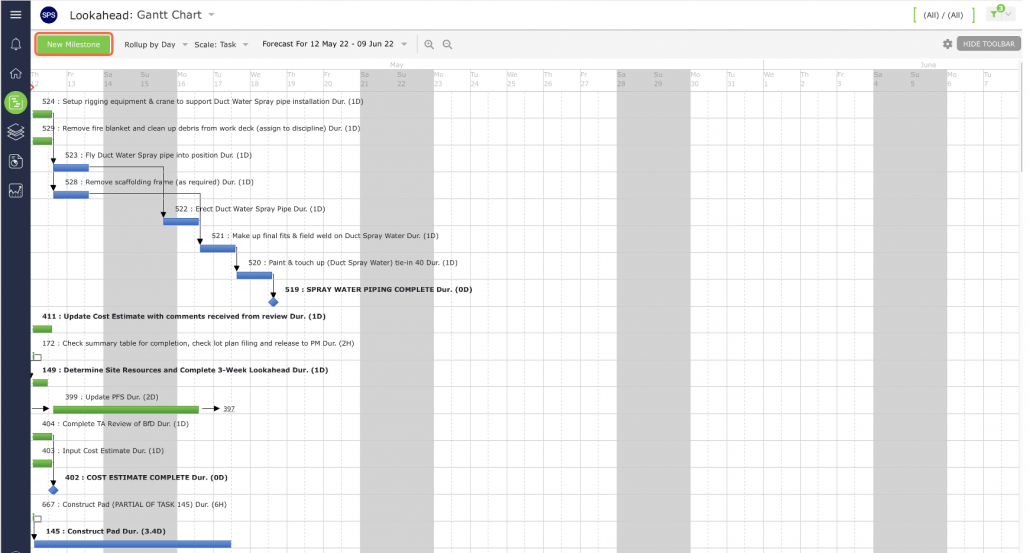

To create a new Production Schedule in the Gantt Chart view, start by inserting a Milestone followed by inserting constraint tasks (see section Insert a Constraint Task). If you are revising an existing Production Schedule, you may also need to insert a new Milestone / Task.

To create a Milestone / Task from the Gantt Chart view, complete the steps below:

  1. From the Main Navigation Bar select the Lookahead, then select Gantt Chart from the dropdown menu.
  1. Click the New Milestone button on the top toolbar to open the Insert New Milestone window.

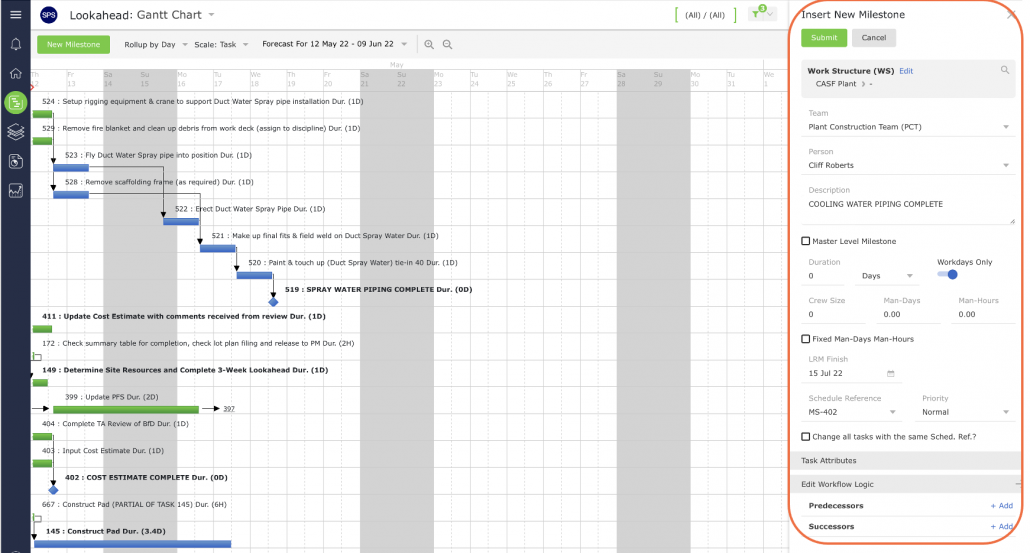

  1. The Insert New Milestone window will open.
  1. In the Insert New Milestone window, enter the Milestone / Task attributes using the guidelines in the table below. If the milestone is a Major Milestone that will be used to measure progress in the Analytics reports, check the corresponding box.

ParameterDescription
Work StructuresSelect values for levels 1-7 of the Work Structures according to the defined Work Structures for your specific project
Team / MemberTeam and member who will own and complete the task
DescriptionStart the description of the task activity with a verb such as ‘Install,’ ‘Develop,’ ‘Formulate,’ ‘Fabricate,’ Approve,’ etc.

Description should be specific and a measurable quantity, no greater than the Planning Horizon (e.g., one day, one week, etc.)

Level of detail should represent measurable hand-off to the successor activity
DurationEstimated time task will take to complete
Forecast StartDefault is based on a ‘Continuous’ Workflow in order to minimize Work-In-Process; other options used are when tasks need to start at a different points to implement different type of control protocol (see section Task Dates for more information)
Schedule ReferenceDisplays the reference to the milestone the task is constraining by default but can be set to any reference based on the intended configuration
PriorityDefault set as ‘Normal’, other options include ‘Low and ‘High’
Workdays OnlyCheck ‘Workdays Only’ if the task will only be completed according to the team’s (or member’s or task’s calendar if enabled)

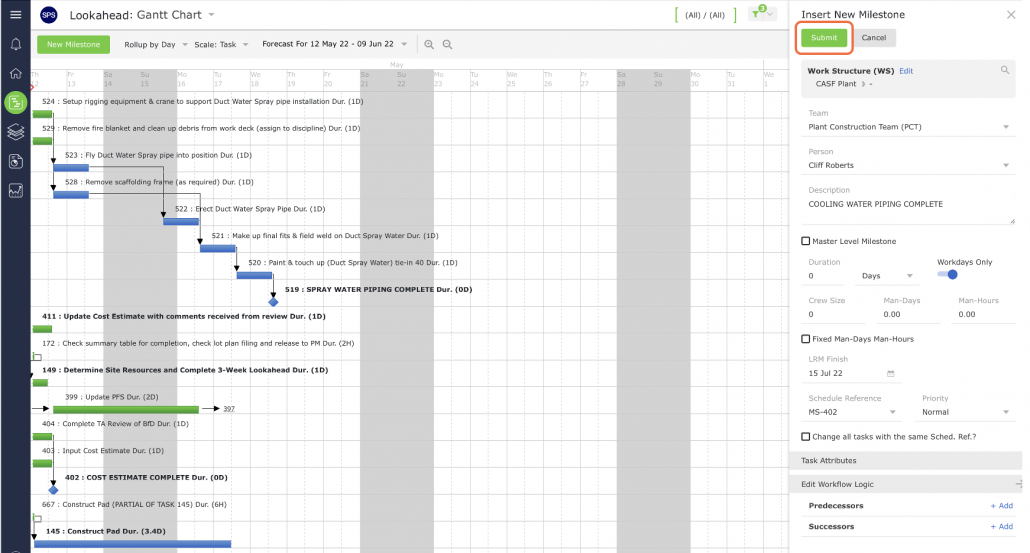

  1. When finished entering the Milestone / Task attributes, click the Submit button. The Milestone / Task will appear in the Gantt Charter view.
