SPS Product ManualStandard ProcessManage Standard ProcessStandard Process Edit ViewCreate New Standard Process – Edit View

To create a new standard process in the Standard Process Edit view, complete the steps below:

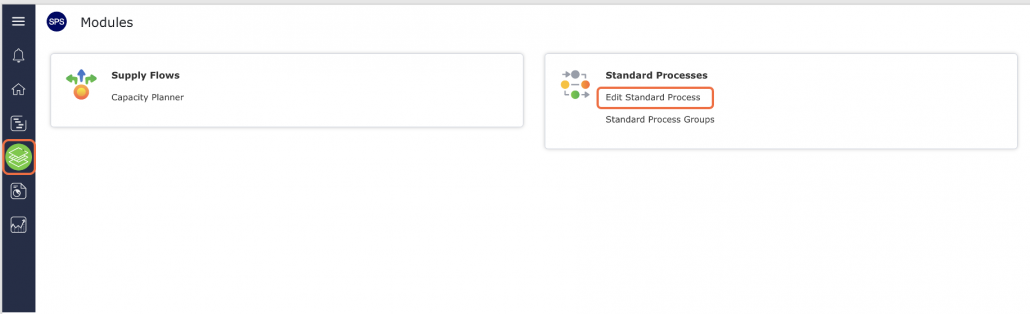

  1. From the Main Navigation Bar select Modules, then select Edit Standard Process.

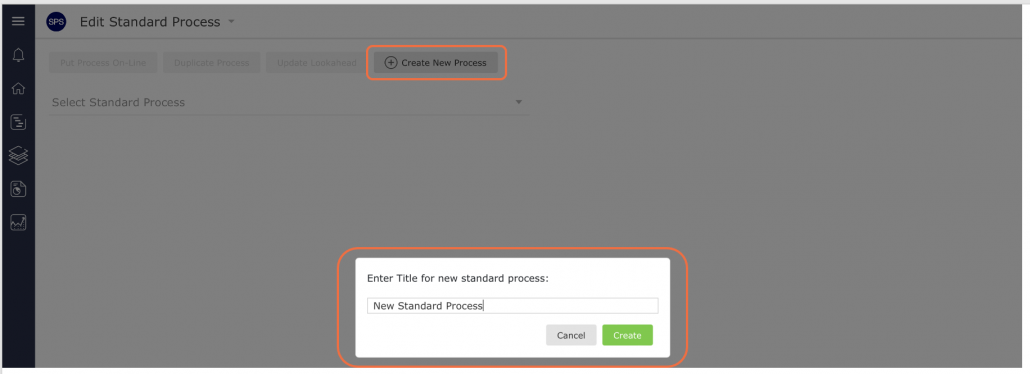

  1. In the Edit Standard Process window, click the Create a New Standard Process button. Enter the new standard process title following the project’s agreed-upon nomenclature then click the Create button. Consistency in naming standard processes is important to facilitate identification when using and editing standard processes in the future; a single project can easily have hundreds of standard processes.

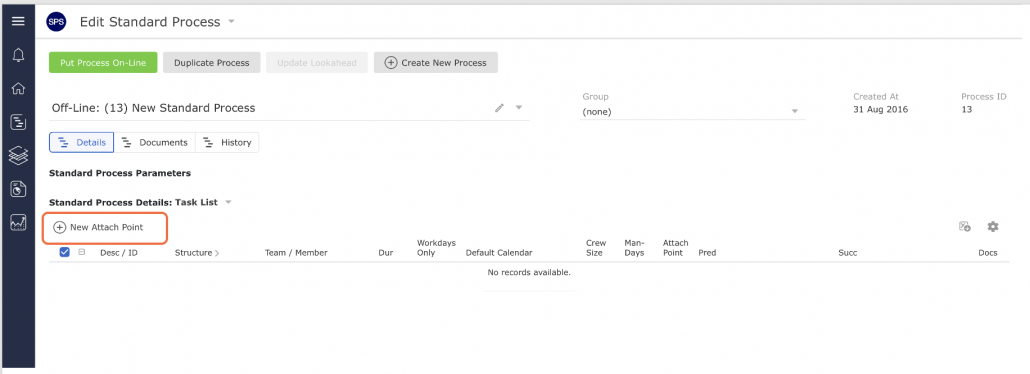

  1. Create the attach point (the end task of the process which will “attach to” the tasks in the Lookahead) used to link to a Milestone / Task in the Production Schedule by clicking the New Attach Point button and the New Attach Point window will open as show in image below.
  1. Populate the attach point details following the parameters below then click the Submit button.
ParameterDescription
Work StructuresSelect values for levels 1-7 of the Work Structures according to the defined Work Structures for your specific project. Values should be left as “(none)” if they are to be inherited from the Milestone / Task that standard process is attached to
Team / MemberTeam and member who will own and complete the task. Should be left as “(none)” if these values are to be inherited from the Milestone / Task that standard process is attached to
DescriptionStart the description of the task activity with a verb such as ‘Install,’ ‘Develop,’ ‘Formulate,’ ‘Fabricate,’ Approve,’ etc.

Task description should be specific and a measurable quantity, no greater than the Planning Horizon (e.g., one day, one week, etc.)

Level of detail should represent measurable hand-off to the successor activity
DurationProposed time task will take to complete
Forecast StartDefault is based on a ‘Continuous’ Workflow; other options used when tasks need to start at a different point than anticipated (see section Task Dates for more information)
  1. Constraint Analysis and task dependency are the core of Production Scheduling. Any task is simply an item of work with a specified duration, for which a single individual is responsible. Within SPS|PM, two tasks are connected by a dependency relationship when work on one task cannot begin before all work on the other has been completed. The dependent task is known as a successor, while the “providing” task is a predecessor or constraint.

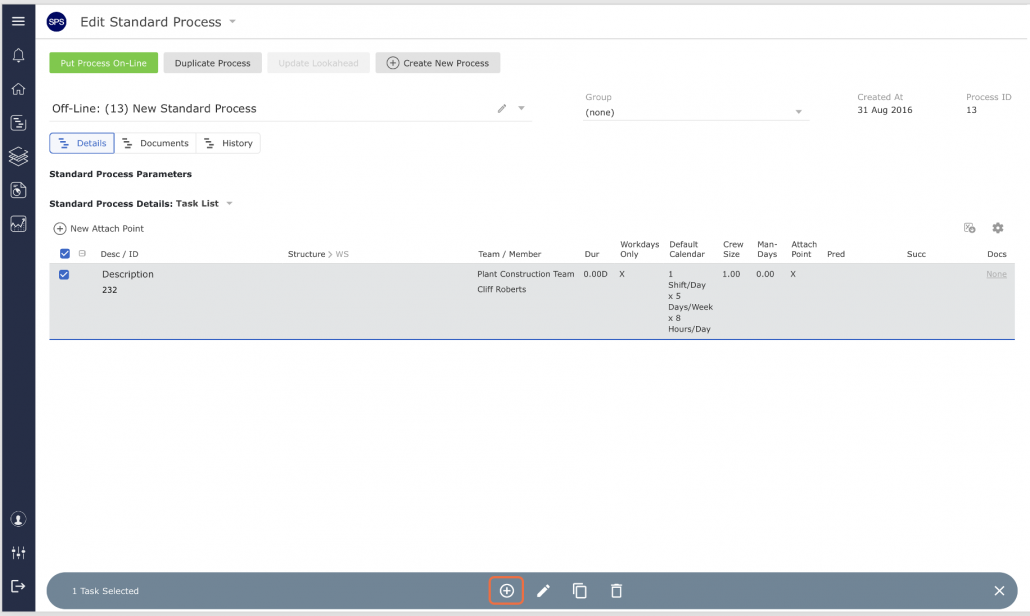

    To add constraints to the attach point, select the attach point by clicking once anywhere on task row. Once selected, the task row will display a blue background as shown below. Then click the New Constraint Task button on the bottom floating toolbar.

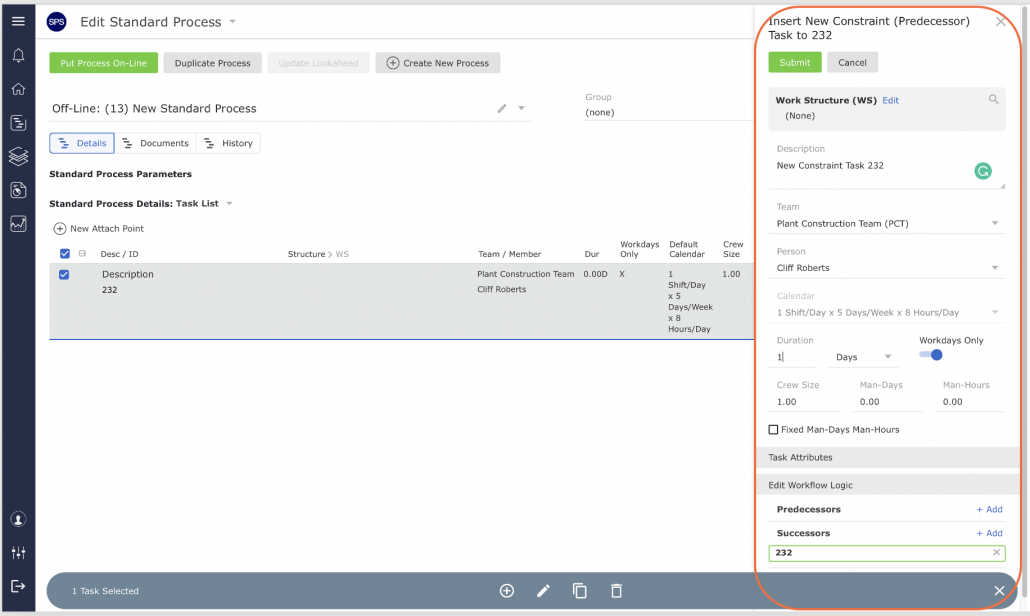

  1. Populate the Insert New Constraint Task (Predecessor) window using the parameters described above in Step 4 and click the Submit button when complete.

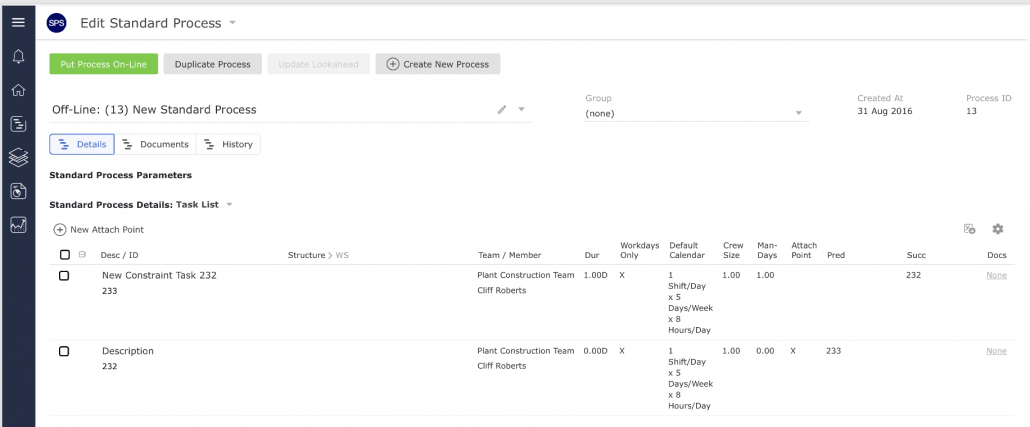

  1. After entering the new constraint task, the task will appear in the process step list and Gantt Chart.
  1. To continue adding constraint tasks, repeat above Steps 5 – 6, selecting the appropriate task or attach point to constrain.
